Home  /  Sectors  /  Education

Sector

Floor screeds for schools and colleges.

Floor screeds for schools, colleges and university estates, including screeds and structural toppings on precast plank decks, programmed around term dates and access.

The work

Floors that fit the school calendar

Education projects often mean working in or around occupied buildings, with hard programme constraints set by term dates and exams. The date is not negotiable, and everyone in the chain knows it.

We plan works into holidays and out-of-hours windows where needed, using fast, low-disruption methods. Our own crews, our own pumps and our own placing booms, so the programme does not depend on somebody else's plant turning up.

Proof, not promises. On an education project the promise that matters is the handover date, and it is made at tender.

On site

Built around your operation, not against it.

We plan the method, phasing and plant so work continues around us and the floor goes down right first time.

The programme

The programme is the specification

On most sectors the specification drives the programme. Here it is the other way round. A summer holiday is roughly six weeks, and into that window go strip-out, structural work, mechanical and electrical first fix, floors, second fix, decoration, furniture and a deep clean, on a site that must be signed off before pupils return. The floor sits in the middle of that chain, and every day it slips comes off the end of somebody else's trade.

  • Drying time is the real risk, not laying time. A screed goes down quickly. Reaching the moisture content that a vinyl or resin covering requires takes considerably longer, and it is the item most likely to push a September handover. It must be designed into the six weeks, not discovered in week four.
  • There is no float. A method that needs a good week of weather, or a plant delivery that might arrive Tuesday, is not a method for a school holiday. Self-delivered plant is worth real money here.
  • Access windows are fixed and short. Term-time work in an occupied school happens in evenings, weekends and half-terms, in areas released and handed back, with safeguarding and separation from pupils as a condition of access.

Scoping

The decision you are actually making

Holiday window or term-time phasing?

A single summer programme and a phased term-time programme are different jobs with different prices. Decide before pricing.

What is the floor covering, and when does it need the base?

The covering manufacturer's moisture requirement sets the drying period, and the drying period sets whether the programme is achievable at all.

Which screed system does the site permit?

If evening working is out because of safeguarding or caretaking arrangements, self-compacting removes the power floating step that forces it.

Is the building occupied during the works?

Safeguarding, separation, agreed routes, DBS requirements and hoarding all follow from this and all affect the price.

Is it a screed or a slab?

New-build teaching blocks, sports halls and plant areas include structural slabs. Refurbishment is usually screed. Many projects are both.

Sports hall or specialist floor?

Sports halls, workshops, science laboratories and kitchens each have their own substrate requirements and should be priced separately rather than averaged.

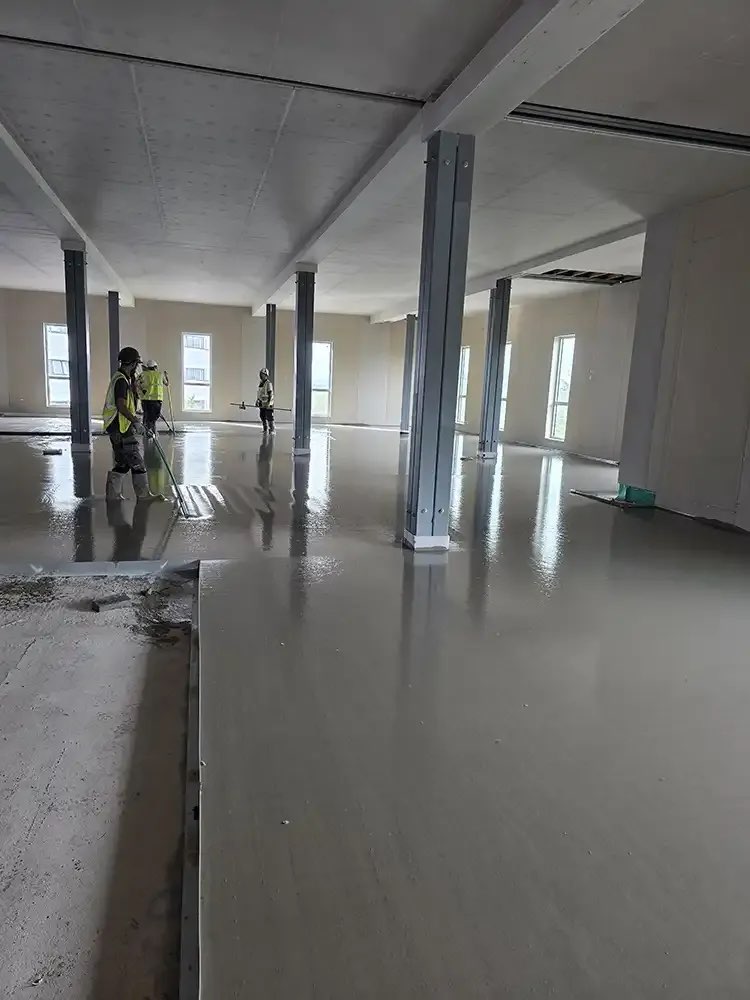

Trent crew levelling pumped flowing screed across an upper floor

Method

Why pumped screed suits education

Speed and containment, for the same reasons they suit healthcare. A pumped screed arrives through a hose rather than a barrow run down a corridor. A large teaching floor plate goes down in a single visit, and the crew leaves the same day. In a six-week window, removing days from the laying operation is worth more than saving a few pounds per square metre.

Self-compacting systems remove the power floating step entirely, which means no crew returning to the building in the evening. On a school with caretaking hours, safeguarding requirements and no appetite for contractors on site after dark, that is often the deciding factor rather than a preference.

Delivery

Constraints handled

Occupied buildings, fixed calendars and safeguarding conditions are normal on this sector. We plan for them at tender, not on the day.

  • Term dates and exam periods. Works planned into holidays, half-terms and agreed out-of-hours windows. Exam periods are treated as hard exclusions, not obstacles.
  • Occupied buildings. Areas released, worked and handed back in sequence, with separation from pupils and staff maintained throughout.
  • Safeguarding. Agreed routes, hoarding, separation and site conduct built into the method statement.
  • Restricted hours. Self-compacting systems remove the late working a power floated screed would require.
  • Upper floors and precast frames. Placing booms deliver screed to upper decks without craning plant up, which matters on constrained urban school sites where there is nowhere to stand a crane. See concrete pumping.
  • Fixed, immovable handover dates. We programme backwards from the return date and tell you at tender if the window does not work. A school that cannot open is not a programme overrun, it is a different kind of problem.

Proof

Evidence and documentation

  • Surface regularity survey against the specified BS 8204 class
  • Moisture readings before floor coverings where we are asked to take them
  • Delivery tickets and batch records
  • Pour records: area, depth, date and conditions
  • Manufacturer's declaration of performance for the system installed
  • RAMS issued and agreed before mobilisation, written to the site's safeguarding and access arrangements
  • Sign-off pack at handover

Constructionline Gold registered. ISO 9001 certified. ACIFC member. Avetta and SSIP accredited. Member of the Nuclear Industry Association.

FAQs

Common questions

Can you work around term times?
Yes. We plan works into holidays, half-terms and out-of-hours windows where needed, and we treat exam periods as hard exclusions.
Can you lay floors in occupied school buildings?
Yes, with clean, fast methods and careful phasing around use, with separation from pupils and staff maintained throughout.
Will the screed dry in time for a September handover?
That is the real question on most education projects, and it depends on the system, the depth, the drying conditions and the moisture content the floor covering requires. It has to be planned into the window rather than assumed.
How do you keep to a fixed handover date?
Realistic programming, self-delivered plant so we are not waiting on a hire company, and honest reporting. If the window does not work, you hear it at tender.
Can you avoid evening and night working?
Usually. Self-compacting screed removes the power floating step that normally forces late shifts, which suits sites with caretaking hours and safeguarding requirements.
Can you screed upper floors in a teaching block?
Yes. Many are built on precast frames, and our track-mounted placing booms deliver screed across upper decks without craning plant up.

Got a flooring or screed project coming up?

Send us the drawings and the specification, and we'll tell you straight whether we can deliver it, and how.

Discuss your project
